Water and Wastewater Infrastructure

New Construction | Repair & Rehabilitation | Emergency Services

Your water and wastewater infrastructure systems may be out of sight, but they’re not out of mind. In fact, when things go wrong, finding a responsive team of specialists becomes one of your most important tasks to tackle, as in right now, or very soon. Expertise and responsiveness matter most.


TFC is an Arizona-based utility contractor specializing in water and wastewater infrastructure new construction, repair and rehabilitation, and emergency services. Our experienced team members are known for comprehensive planning, realistic scheduling, reliable cost estimating, and excellent performance in the field.


We work as both prime and subcontractor, and are adept at all types of project delivery, including Design-Bid-Build, Construction Manager-at-Risk (CMAR), Design-Build, Job Order Contracting (JOC), and emergency repair work.


From small repairs to large and complex phasing and maintenance of plant operations (MOPOs), TFC’s team of utility construction specialists is equipped and available to keep your infrastructure operating to meet your community and user needs.

SERVICES

Specialty Utility Contractors

Proven Constructability | Available Equipment | Capable Employees

Pre-Construction

Wet Utilities

Pipeline Rehabilitation

Bypass Plumbing

Water and Wastewater Facilities

Slip-Lining

Sewer Rehabilitation

Certified HDPE Fusion Services

Grading and Paving

Concrete Flatwork and Structures

TEAM

Local Utility Construction Professionals

Valley Experience | Proven Expertise | Solutions Focus

PROJECTS

Consistently Meet Owner Expectations

Responsive Service | Efficient Execution | Safety First

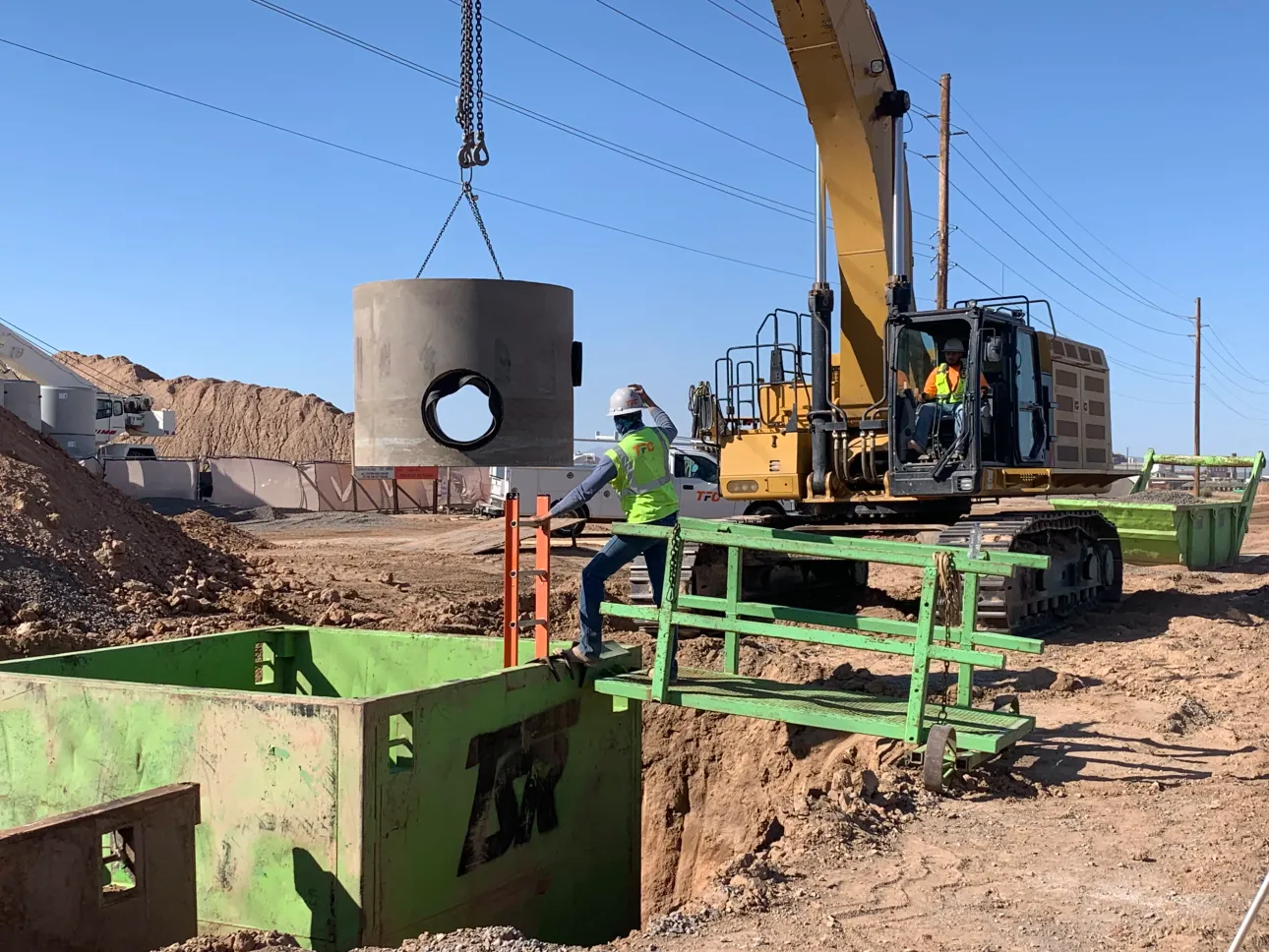

FORCEMAIN REPAIR - WESTERN CANAL

VICTORY SEWER OFFSITE SEWER - LITCHFIELD PARK, AZ

PROJECT HIGHLIGHTS


  • Client: The Base Phase 1, LLC
  • General Contractor:  Willmeng Construction
  • Project Cost: $2.366 million
  • Scope: Offsite sewer line, manhole installations, and asphalt improvements
  • Sewer Line Installation:
  • Installed 1,766 feet of 15” SDR-35 PVC
  • Installed 2,858 feet of 12” SDR-35 PVC
  • Installed 12 EA 60” manholes with 30” ring and cover, coated with insecticide paint and sewer shield
  • Asphalt Replacement:
  • Replaced 4,500 square yards of asphalt
  • Additional Services:
  • Confined space entry for pipe cleaning and preparation
  • Traffic control and public outreach
  • Multi-jurisdictional coordination



GILBERT SYSTEM WIDE FORCE MAIN REHABILITATION

  • Slide title

    Write your caption here
    Button
  • Slide title

    Write your caption here
    Button
  • Slide title

    Write your caption here
    Button
  • Slide title

    Write your caption here
    Button
  • Slide title

    Write your caption here
    Button
  • Slide title

    Write your caption here
    Button
  • Slide title

    Write your caption here
    Button
  • Slide title

    Write your caption here
    Button
  • Slide title

    Write your caption here
    Button
  • Slide title

    Write your caption here
    Button

PROJECT HIGHLIGHTS


  • Extensive Scope: Rehabilitation of approximately 22 miles of force mains across 15 lift stations throughout Gilbert.
  • Comprehensive Approach: Included condition assessment, evaluation of repair methods, and implementation of various rehabilitation techniques.
  • Diverse Techniques: Utilized open-cut replacement, slip-lining, CIPP, and SIPP based on specific site requirements.
  • Wide Range: Force main diameters varied from 4-inch to 24-inch, requiring diverse rehabilitation approaches.
  • Infrastructure Upgrade: Replaced corrodible pipe materials to eliminate failures, increase public safety, and improve sustainability.
  • Additional Work: Installed new valves and performed recoating where necessary.
  • Complex Logistics: Managed extensive traffic control and public outreach efforts across multiple sites.
  • Operational Continuity: Implemented complex bypass pumping scenarios to maintain uninterrupted wastewater service during construction.
  • Coordination: Worked closely with Town operations to minimize disruptions to service.
  • Long-term Impact: Significantly enhanced the reliability and longevity of Gilbert's force main system.

HARDY DRIVE DIVERSION MANHOLE RENOVATION

TEMPE WASTEWATER COLLECTION SYSTEM

PEORIA LOGISTICS PARK

PROJECT HIGHLIGHTS


  • Competitive Bid Win: Awarded through competitive bid with Caliente Construction under City of Tempe General Construction Services JOC.
  • High Self-performance: Self-performed over 87% of the project work.
  • Manhole Replacement: Removed and replaced three deteriorated concrete manholes on 24” and 30” sewer lines with two new 72” and 96” corrosion-resistant Armorock Polymer manholes.
  • Hydraulic and Odor Improvements: Enhanced hydraulic characteristics and minimized foul odors on the sewer line.
  • High-traffic Area: Project located at the intersection of Hardy and 17th Place near ASU campus.
  • Sewer Bypass Systems: Installed two sewer bypass systems on 30” and 12” lines, including 24/7 pump-watch, entirely self-performed.
  • Traffic and Public Coordination: Collaborated with City of Tempe for traffic control planning and public outreach, communicating construction impacts to adjacent homeowners.
  • Additional Work: Included pavement removal/replacement, storm drain re-routing, CCTV inspection, air testing, and striping replacement.
  • Timely Completion: Completed the project in less than three weeks to meet holiday traffic restriction requirements.

PROJECT HIGHLIGHTS


  • Emergency Response: Engaged under Town of Gilbert's emergency procurement JOC due to 18” DIP wastewater forcemain failure.
  • Immediate Mobilization: Deployed crews, equipment, and materials within hours, working continuously for 36 hours.
  • Stabilization and Bypass: Stabilized the failure site and implemented a 4,100-foot high-line sewer bypass to prevent overflow at Islands Lift Station.
  • Condition Assessment: Performed condition assessment of the forcemain while bypass was in place.
  • Collaboration: Assisted Town and Hazen Engineering with developing a permanent repair solution.
  • Permanent Solution: Trenching and installing a permanent parallel 18” HDPE forcemain across McQueen Road.
  • Redundancy and Future-proofing: Designed the new setup to handle existing flows and provide future redundancy.

PROJECT HIGHLIGHTS


  • Collaborative Project: Partnered with Insituform Technologies on a Design-d-Build project for the City of Tempe.
  • Scope of Work: Managed sewer bypass pumping, sewer point repairs, manhole inserts, reconstructions, and traffic control across multiple city locations.
  • Challenging Bypass Operation: Self-performed a complex sewer bypass at Kyrene & Guadalupe Rd. intersection, a critical area in Tempe.
  • Bypass Specifications: Designed for a flow rate of 10 million gallons per day (MGD) with a suction lift of 22 vertical feet.
  • Technical Expertise: Addressed limited Net Positive Suction Head Available (NPSHA) for the pumps, showcasing advanced engineering capabilities.
  • Key Contributions: Team members were instrumental in the design, calculations, and submittals for the successful 36” Cured-In-Place Pipe (CIPP) installation.

PROJECT HIGHLIGHTS


  • Subcontracted Project: Worked under a General Contractor for the Peoria Logistics Park, a 158-acre industrial park in southern Peoria, Arizona.
  • Cost: $1.425 million.
  • Market: Site Utilities.
  • Strategic Location: Near Loop 101 and Grand Avenue (US 60), with easy access to major interstates and 6-9 miles from I-10.
  • Site Readiness: Shovel-ready with existing infrastructure and zoning for industrial use, suitable for semiconductor facilities.
  • Scope: Onsite and offsite utility installations and asphalt improvements for a 155,000 SF tilt-up, build-to-suit distribution facility.
  • Utility Infrastructure: Water, sewer, gas, electric, and communication services adjacent to the property, provided by City of Peoria, Southwest Gas, and CenturyLink.
  • Water Line Installation:
  • Installed 5,361 feet of 4", 6", and 8" DIP.
  • Installed 1 16x8" Tapping Sleeve.
  • Installed 9 8" Gate Valves.
  • Installed 13 6" Gate Valves.
  • Installed 4 4" Gate Valves.
  • Installed 12 Fire Hydrants.
  • Completed 5 Vertical Realignments.
  • Installed 1 Blow Off.
  • Installed 1 4" Backflow.
  • Installed 2 Remote FDCs.
  • Sewer Line Installation:
  • Installed 959 feet of 6" and 8" PVC.
  • Installed 3 48" Manholes.
  • Installed 2 6" Cleanouts.
  • Storm Drain Installation:
  • Installed 111 feet of 18" and 24" HDPE.
  • Irrigation Line Installation:
  • Installed 629 feet of 24" RCP.
  • Installed 1 Irrigation Box.
  • Asphalt Replacement:
  • Replaced 794 square yards of asphalt.
  • Reliable Power Supply: SRP operates a major substation and power generation facility across the street, ensuring steady power.
  • Developer Partnership: The VanTrust Group, developer/partner on the site, facilitates build-to-suit/lease-back facilities.

SAN TAN LIFT STATION & FORCE MAIN REPAIR

PROJECT HIGHLIGHTS


  • JOC for Town of Gilbert
  • Retrofit / rehab of existing lift station including bypass pumping
  • Precon services from “napkin plans” with GMP
  • Public outreach and coordination
  • MOPO / LOTO coordination
  • Confined space entry
  • HDPE butt fusion welding

TOQC - POWER RD 42" CONCRETE PIPE REHAB

PROJECT HIGHLIGHTS


  • JOC for Town of Queen Creek
  • 5,180 LF of new 42” CIPP lining and manhole rehabilitation
  • Pipe cleaning & preparation, PVC lining removal, and sewer bypass pumping
  • Precon services
  • Public outreach and coordination
  • Trenchless technology (HDD)
  • Traffic control

PHASE 1 - SOSSAMAN WATER SUPPLY

PROJECT HIGHLIGHTS


  • JOC for Town of Queen Creek
  • 4,188 LF of new 12” waterline, including 20” HDD bore w/ 12” HDPE carrier pipe
  • Precon services
  • Public outreach and coordination
  • Trenchless technology (HDD)
  • HDPE butt fusion
  • Multi-jurisdictional coordination

EXPERTISE

Proven Utility Construction Capabilities

Accurate Estimating | Technical Expertise | Safe Construction Practices

Simple or complex, utility construction requires excellent communication and coordination with owners, third parties, and community members. We build strong relationships with client team members to optimize schedules and permitting agencies to avoid delays. We regularly work with approved public outreach professionals to advise of construction impacts. We prioritize operability, maintainability, and minimizing impacts to end users and the public.



Our team’s technical expertise includes conventional wet utility work using innovative construction techniques, including trenchless pipeline installation methods including Slip-Lining, HDD and CIPP, Certified HDPE Fusion Services and Complex Bypass Pumping.


We have a strong track record of planning and coordinating maintenance of plant operations (MOPOs), and work with material and equipment suppliers so owner-purchased equipment installation proceeds smoothly for project success.
